RANGIURU BUSINESS PARK

It’s been a year for the books, when we reflect on the progress at the Rangiuru Business Park. As the project transitioned from a foundational development to early market engagement and delivery, it remains a critical enabler of economic growth and employment in the Bay of Plenty.

Three Major Milestones Achieved

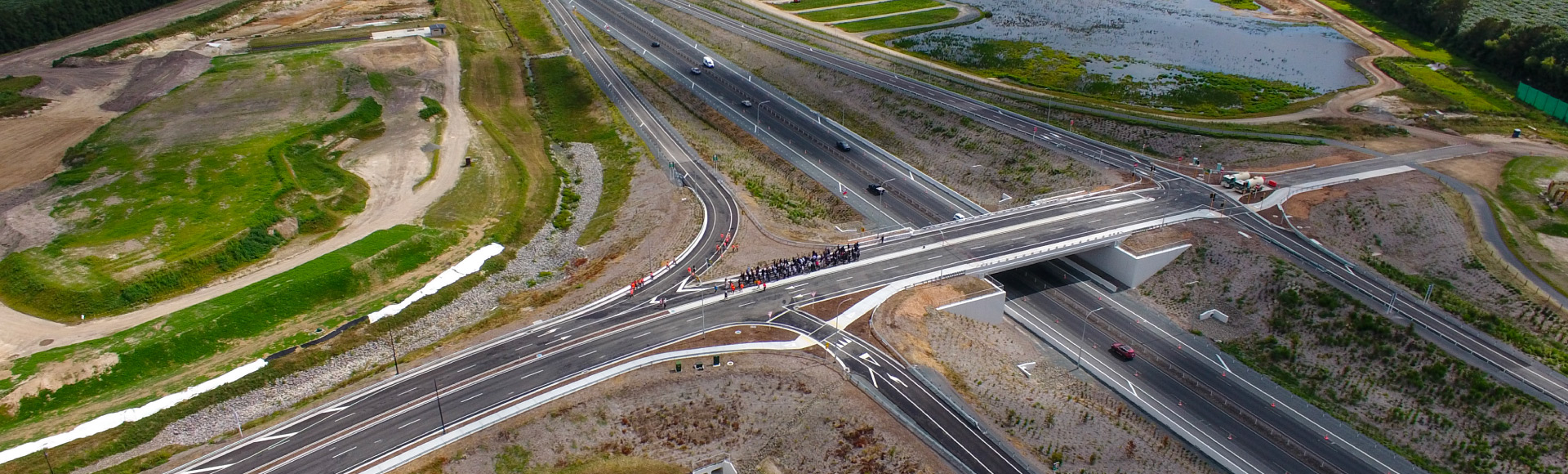

Three significant milestones were achieved in the first half of 2025, commencing with the official opening of the Rangiuru Business Park motorway interchange. This critical infrastructure development marks a transformative step forward for the Rangiuru Business Park, unlocking direct access to State Highway 2 and enhancing connectivity for freight, logistics, and future tenants. The diamond interchange has been built to support future transport needs of the expanding Eastern Corridor and reinforces the Rangiuru Business Park’s strategic value as a catalyst for regional growth.

Attended by the Minister for Regional Development, Hon Shane Jones, alongside elected representatives, iwi, and local leaders — recognising the collaborative effort behind the project, which has been funded by Quayside with support from the Government’s Provincial Growth Fund. This milestone sets the stage for accelerated development and investment in the years ahead.

April brought the first sale of land within the Rangiuru Business Park — an 8.7-hectare site representing approximately 60% of Stage 1a, signalling strong market interest in the Rangiuru Business Park’s offering.

To top things off, we received the issuance of first Records of Title by LINZ. This signifies a vesting of bulk infrastructure to the Western Bay of Plenty District Council and authorities. This milestone represents the hard work by Quayside and its wider partners over numerous years.

Project Progress

Sizable progress has been made at the Rangiuru Business Park over the past year, with several key development milestones achieved. Two wastewater pump stations and the rising main were completed and vested to Council in January 2025, marking a major step forward in delivering essential infrastructure for the Rangiuru Business Park. In February, the first stage of the internal roading network was finalised, providing the foundation for future transport and logistics operations within the Rangiuru Business Park.

The physical delivery of infrastructure has continued at pace, supported by the processing of more than 30 consents and engineering approvals. These have enabled the construction of critical assets, including the State Highway 2 interchange and a comprehensive internal road network. These transport links are now fully operational, offering seamless access to and through the Rangiuru Business Park. Approximately 50% of the total infrastructure has now been completed including roading, stormwater systems, utilities, and landscaping — representing a major step toward full operational readiness.

Streetscape and swale planting is underway and is already enhancing the visual appeal of the area. Stage 1 of the wetland is also complete, with around 123,500 plants installed across both wetland and swales in this recent phase of planting. The final shaping of the pond and installation of the outlet culvert have enabled the wetland to become fully operational, contributing to the site’s ecological and stormwater management goals.

In June 2025, 223/224 certification was received, marking a key regulatory milestone. Construction has also commenced on the 5,300m3 water reservoir and booster pumps, which will provide high fire water capacity for the Rangiuru Business Park. Ground improvements are in progress, and the concrete tank will feature a mural to enhance the visual identity of the site. Substation works have also begun, supporting the Rangiuru Business Park’s future energy needs.

The scale and complexity of the development has delivered substantial employment benefits. During the construction phase, the project has supported approximately 500 jobs across consultants, contractors, and professional services—contributing meaningfully to the regional economy.

Sales Activity

Market activity, though moderated by broader economic conditions, is showing encouraging signs. Enquiries are steadily emerging from the logistics, light industrial, and regional service sectors —driven by a clear scheme plan, transparent pricing schedule, and proactive engagement with early partners.

While the commercial property market remains challenging, strong sales performance at nearby developments and early momentum points to a positive outlook. As the Rangiuru Business Park continues to evolve, it is poised to become a vibrant hub for business, employment, and innovation in the Bay of Plenty.

With 60% of Stage 1A already sold and further negotiations ongoing, demand remains strong. Construction of Stage 1B is now underway and officially on the market, marking another exciting milestone in the Rangiuru Business Park’s growth.

0
%

of Stage 1A SOLD

Wetland Development

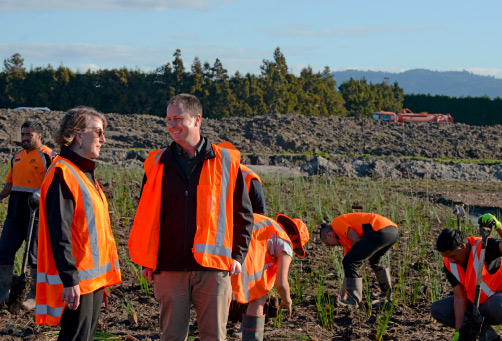

This year, the wetland development has flourished, in more ways than one. Over 102,500 additional plants have been planted this season, with exceptional growth observed in the first stage of planting. Remarkably, there has been minimal plant loss, a rare achievement in wetland construction attributed to the fertile land and deep local matauranga (knowledge) guiding the project.

The wetland has become a thriving habitat, attracting a diverse range of birdlife — including native species like Spoonbills, which are typically shy and were previously absent from the area. Their arrival is a strong indicator of the ecological health and transformation underway, even as construction continues nearby.

A visual feature that has evolved this year was the raised tree island. Elevated slightly, it now serves as a central ecological and cultural space, designed to guide visitors through different zones.

The tree island promises a unique immersive experience once the bush matures, with views of the maunga (mountain) Rangiuru and a historical connection to the whenua.

Beyond environmental outcomes, the project has continued to foster a strong sense of pride among the planting team, many of whom whakapapa to Tapuika and are connected to the whenua they now work on.

The team culture has flourished over the past 12 months, with a focus on learning and growth. Individuals have expressed deep pride in their contributions, transforming initial uncertainty into a shared sense of achievement and ownership.

The wetland is more than just a stormwater solution — it’s a living testament to what can be achieved when community, mana whenua, ecology, and enterprise align.
